RAVAM REQUEST A BRIEFING →
PHASE 1 · UAV AEROMAGNETIC PIPELINE CORRIDOR SURVEY

Establish the physical reality of the corridor.

A non-contact field program to improve pipeline localization, screen magnetic anomalies, prioritize direct verification and establish the baseline for future monitoring.

Controlled pipeline field survey and correlation test
Phase 1 · controlled field evidence and correlation
01LocateDetermine pipeline position
02DefineIdentify segments and joint features
03ScreenPrioritize areas of interest
Why Phase 1

Start with corridor reality before designing the larger system.

Swamps, flooded areas, deep snow, vegetation and difficult terrain can interrupt conventional field programs. Historic route information may also be incomplete or no longer match present conditions.

01 · LOCATE

Determine pipeline position.

Improve understanding of the buried steel pipeline alignment and route continuity.

02 · DEFINE

Identify segments and joints.

Map magnetic features associated with pipe sections, joint locations and weld areas.

03 · SCREEN

Prioritize areas of interest.

Identify magnetic signatures and changes that may justify targeted ground verification.

WHAT THE METHOD SUPPORTS

Corridor localization, anomaly screening, route and segment intelligence, comparison between controlled surveys and prioritization of follow-up locations.

ENGINEERING BOUNDARY

A magnetic anomaly is not automatically a confirmed defect. Defect classification and sizing require appropriate field correlation and operator-approved engineering methods.

Phase 1 Workflow

Scope. Acquire. Process. Verify. Decide.

Every work package begins with the operator's records and decision needs, then builds evidence through controlled acquisition and selected verification.

01

Define the corridor

Review alignment records, construction data, known features, access limits and integrity questions.

02

Survey the corridor

Collect repeatable UAV magnetic data and reference measurements under documented conditions.

03

Build the evidence

Apply quality control, correction, georeferencing, mapping and anomaly interpretation.

04

Correlate selected locations

Compare observations with operator records and appropriate targeted field checks.

05

Prioritize action

Deliver a ranked verification plan and recommendations for the next integrity step.

Survey System

Two magnetic measurements. One controlled survey workflow.

The payload and reference measurements are configured around the corridor, terrain, safety and repeatability requirements of the work package.

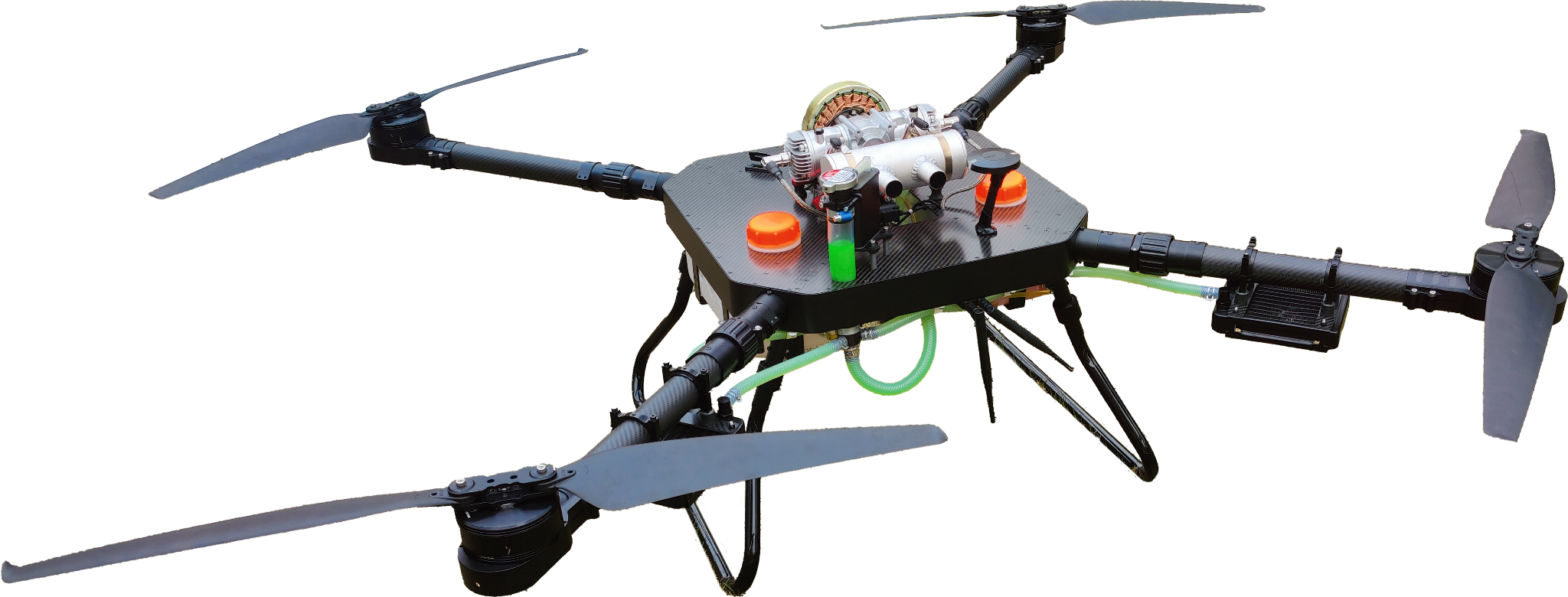

UAV configured with pipeline survey payload
UNMANNED AERIAL VEHICLE

Controlled corridor acquisition.

Carries the survey payload along flight lines configured for terrain, safety and repeatability.

Three-component ferrosonde magnetometer
THREE-COMPONENT FERROSONDE MAGNETOMETER

Directional magnetic response.

Measures X, Y and Z magnetic-field components and captures directional changes in pipeline response.

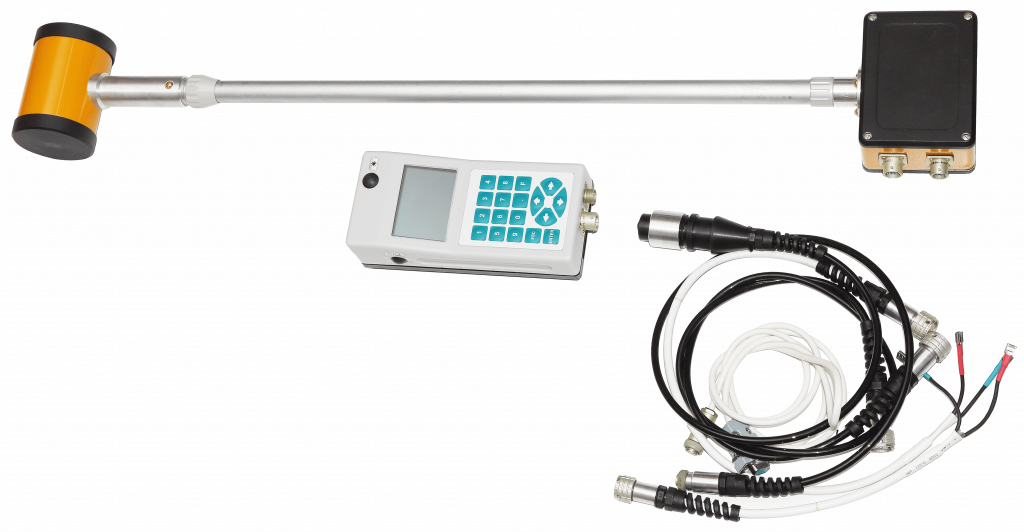

POS proton magnetometer
POS PROTON MAGNETOMETER

Absolute scalar-field reference.

Provides an absolute scalar-field reference for background and consistency checks.

Pipeline GIS and geospatial processing
RAVAM PROCESSING & GIS

From field measurements to operator-ready evidence.

Supports quality control, transformation, anomaly localization and operator-ready reporting.

Controlled Evidence

Welds, joints and introduced changes produce measurable magnetic response.

The supplied controlled test data demonstrate measurable magnetic signatures and changes. They support screening methodology development; they do not by themselves establish field defect classification.

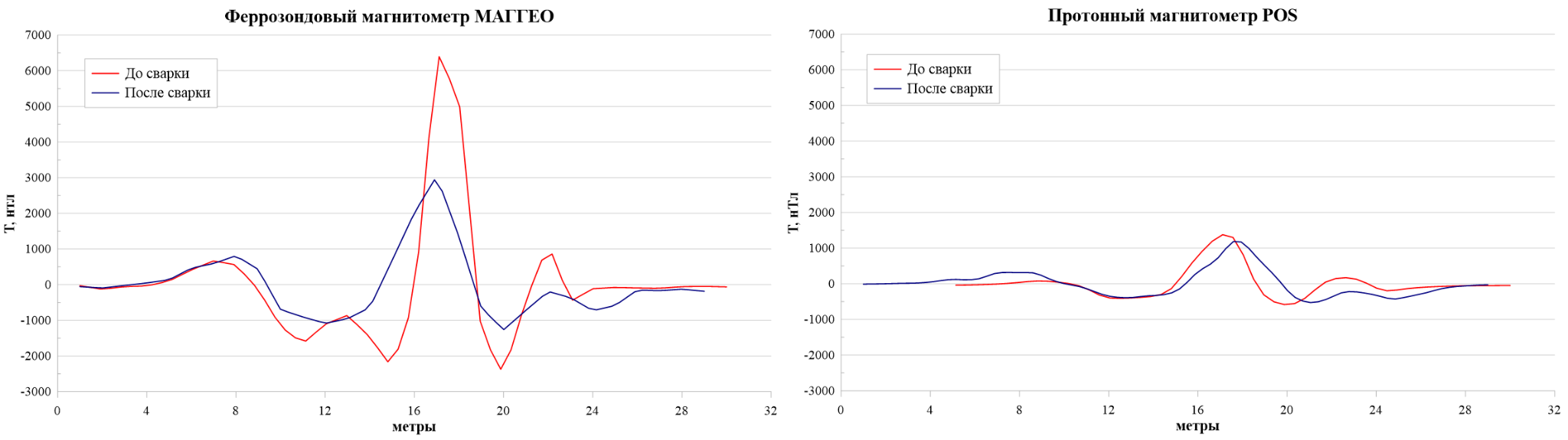

Controlled ferrosonde and proton magnetometer response before and after welding pipe segments
Controlled comparison of ferrosonde and proton-magnetometer response before and after welding pipe segments.
FERROSONDE RESPONSEHigh-amplitude response around joint features.

The controlled configuration shows pronounced response around pipe-joint features.

WELD-SEAM RESPONSEResponse changes after welding.

The supplied test reports a reduced anomaly amplitude after the pipe segments were welded.

PROTON REFERENCENo significant before-and-after change in this experiment.

The proton magnetometer serves a different measurement role in the controlled survey system.

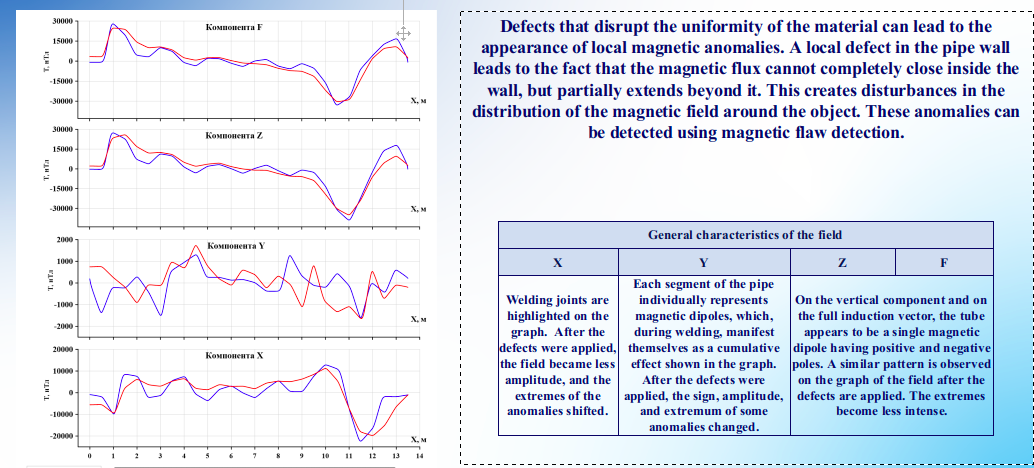

Magnetic component response after controlled defects were introduced
Controlled experiment showing changes in magnetic components after defects were introduced.

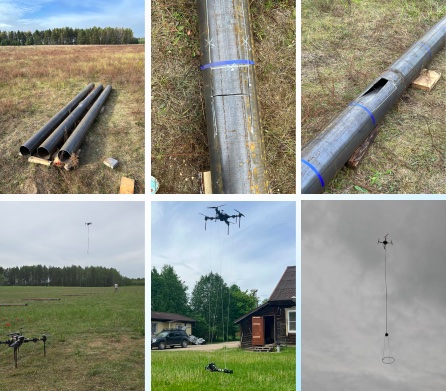

Interpretation boundary: changes in amplitude, extrema and local minima can support anomaly screening. The response is not, by itself, a field defect classification.

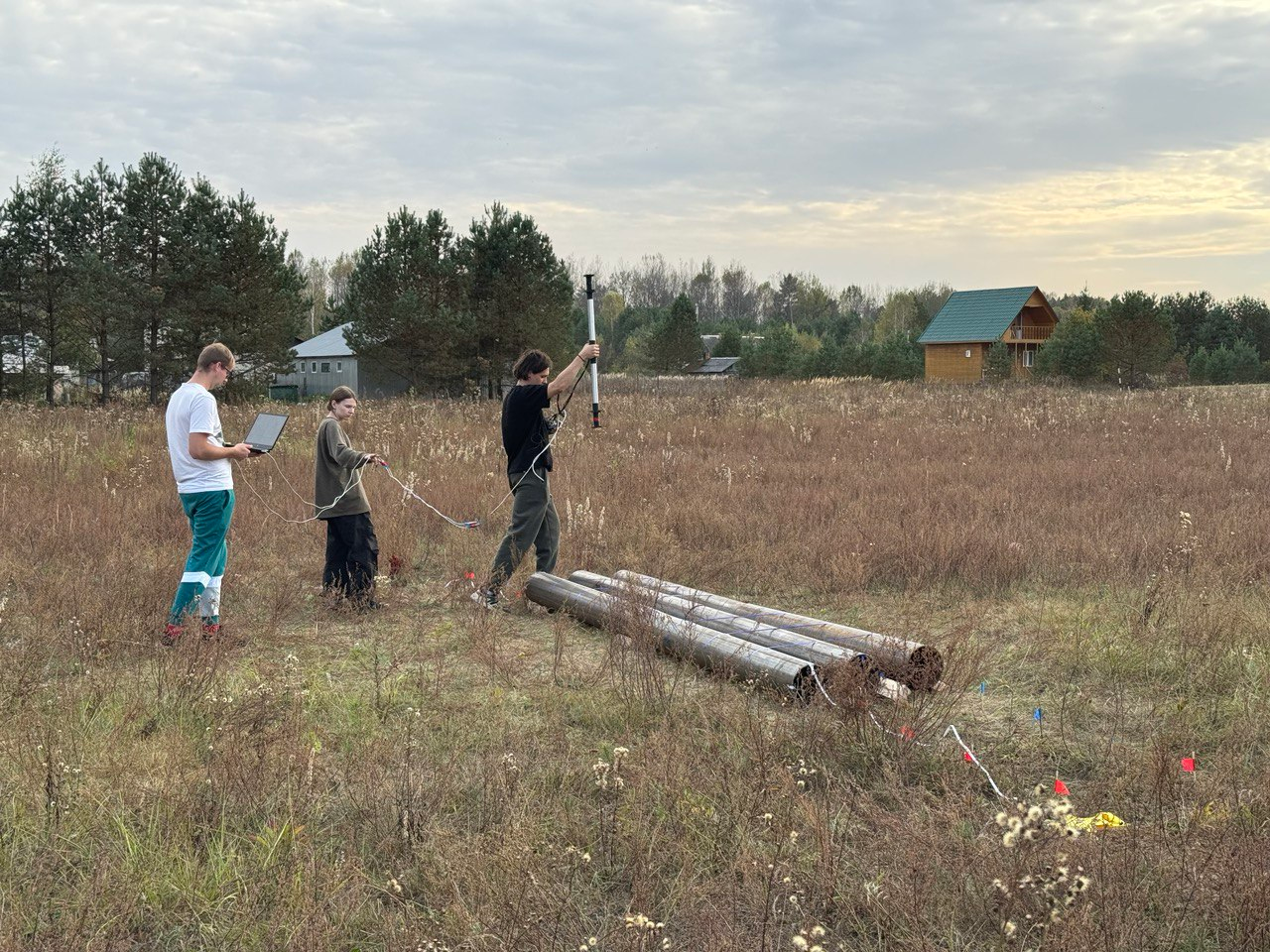

Controlled pipeline field test
Controlled field test environment used to correlate measurements with known pipeline features.
Field Correlation

Repeatability depends on survey control.

Every campaign documents the conditions that influence magnetic data so later surveys can be compared on a consistent basis.

GeometryFlight-line position, height and orientation
BackgroundReference measurements and local magnetic environment
InterferenceNearby ferromagnetic objects and operational constraints
ProcessingDocumented correction, transformation and interpretation history
Phase 1 Deliverables

Outputs built for pipeline integrity teams.

The survey is delivered as traceable engineering decision support, with method, evidence, confidence and limitations documented.

01Surveyed corridor alignment and segment layer for GIS
02Quality-controlled magnetic-field dataset
03Mapped anomaly register with confidence and priority
04Recommended direct-verification locations
05Technical report with method, constraints and interpretation
06Baseline for repeat monitoring and time-series comparison
Expansion Path

Use Phase 1 evidence to select the right next step.

Verified corridor intelligence can feed a digital twin, enterprise integration and recurring monitoring program without forcing the operator into a predetermined hardware or software configuration.

NEXT STEP

Standards & Qualification

Agree the verification, acceptance and independent-review pathway for the method.

VIEW ASSURANCE →
EXPANSION

Monitoring & Operations

Add scheduled patrols, NEST infrastructure, multi-sensor observations and operational reporting.

VIEW MONITORING →
INTELLIGENCE

Digital Twin & AI

Connect the corridor baseline to structured asset data, change history and validated analytics.

RAVAM PLATFORM →
Phase 1

Define the first corridor.

Start with the available pipeline records, a bounded route section and the integrity decisions the survey must support.

REQUEST A PIPELINE BRIEFING →
